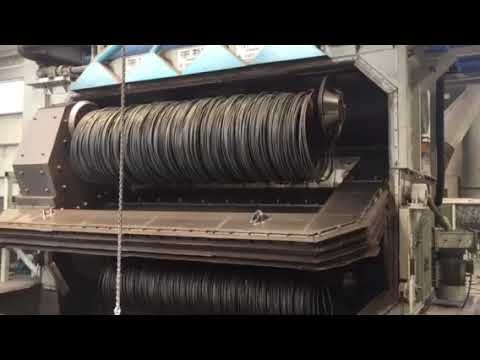

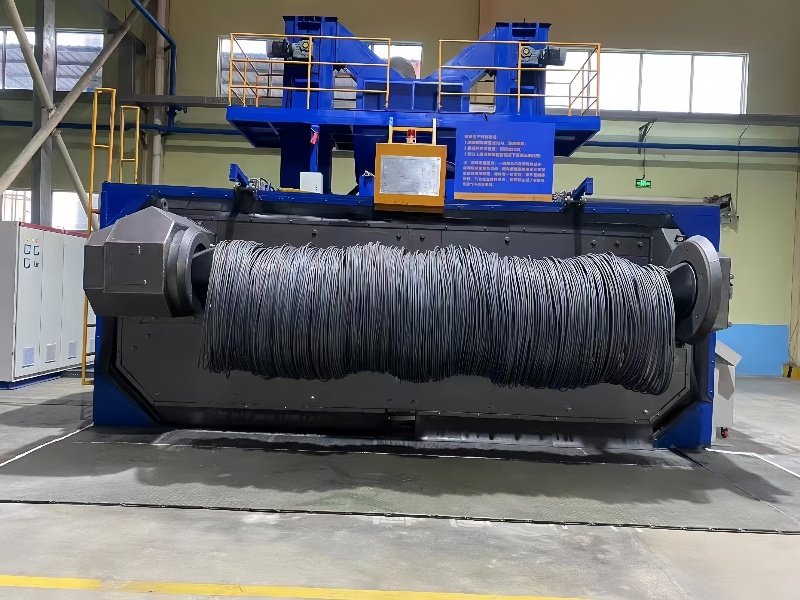

Integrating shot blasting into a steel wire production line starts with a process assessment. The cleaning method must suit the wire material, incoming scale, handling arrangement and downstream requirements. This guide describes engineering planning steps; it does not report a customer installation or measured project results.
Define the Surface-Cleaning Problem
Map the wire's route from incoming material through cleaning, inspection and the next operation. Record where material waits, which surface conditions are rejected and how rework is handled. Separate a cleaning bottleneck from problems elsewhere in the line.
Shot blasting may be an option for removing rust and scale, but it does not repair underlying material defects or automatically replace every function of a chemical treatment. Compare process options against the requirements of drawing, coating or other downstream operations.
Establish the Design Inputs
| Design input | Information needed |
|---|---|
| Wire and material | Grade, diameter range, geometry, coil or length dimensions and weight |
| Incoming surface | Type and variability of scale, rust, oil and other contamination |
| Finished surface | Required cleanliness, profile, dimensional limits and contamination restrictions |
| Production | Product mix, planned hours, changeovers, target output and handling arrangement |
| Site | Available space, foundations, utilities, extraction and access |
| Interfaces | Payoff, take-up, tension control, buffers, controls and downstream equipment |
Use drawings and representative samples to resolve uncertain inputs. A specification for continuous wire is not interchangeable with one for loose coils or straight lengths.
Diagnose Constraints Before Selecting Equipment
| Observation to investigate | Engineering question |
|---|---|
| Remaining scale | Is the incoming condition outside the process window, or is coverage inadequate? |
| Uneven surface | How do movement, shielding, abrasive condition and settings affect exposure? |
| Material waiting | Is cleaning, handling, changeover or downstream inspection limiting flow? |
| Rework | What defect categories are recorded, and which can be linked to surface preparation? |
| Maintenance interruptions | Which components and operating conditions account for the stops? |
A causal assessment matters. A change in product mix or incoming material can alter output and rejection figures even when the cleaning process has not changed.
Develop a Candidate Configuration
Review the blast arrangement, wire movement, abrasive recovery and extraction as an integrated system. Specify adjustment ranges and access for wear-part replacement. For inline equipment, define the response to stopped wire, loss of tension and downstream faults.
Multiple-wire processing should only be proposed where the handling and blast-coverage design support it. Do not assume that adding paths increases usable output without testing shielding, stability and cleaning consistency.
Dust collection, guarding and controls need an appropriate safety assessment for the material and site. Including a dust collector in a quotation does not by itself demonstrate exposure control or local compliance.
Qualify the Process with Samples
Agree the trial conditions and acceptance criteria before running samples. Include the more demanding combinations of diameter, material and incoming surface within the proposed range.
Record settings, abrasive condition, feed speed, inspection locations and any manual work required. Inspect cleanliness and surface profile separately where both are specified. Check for dimensional or surface effects that could interfere with subsequent processing.
Compare alternative methods using the same incoming condition and finished-surface requirements. Include handling and inspection time when estimating the complete cycle.
Plan Installation and Handover by Milestones
- Design review: confirm inputs, drawings, responsibilities and exclusions.
- Site preparation: verify foundations, access, utilities, extraction and interface readiness.
- Factory acceptance: complete the agreed checks and document outstanding items.
- Installation and integration: position, connect and inspect the system using approved procedures.
- Site acceptance: test the complete line with representative production material.
- Training and handover: provide operating, maintenance and troubleshooting instructions, plus the agreed parts documentation.
Set dates and staffing from the actual project plan. There is no universal installation duration or training period that can be promised from a generic guide.
Build a Measurement Plan Before Claiming Improvement
| Measure | Definition to agree |
|---|---|
| Output | Accepted production over a stated period, with product mix and operating hours |
| Cleaning cycle | Start and end points, including or excluding handling as explicitly stated |
| Rework and scrap | Separate categories, denominator and reason codes |
| Energy | Metering boundary, relevant equipment and accepted production quantity |
| Labor | Tasks and hours included, rather than headcount alone |
| Abrasive and maintenance | Consumption, wear parts, inspection intervals and stop classifications |
Collect a documented baseline and use comparable operating conditions for any later evaluation. Do not attribute every change in a plant metric to the new cleaning equipment. Numerical results require measurement records and a clear calculation basis.
Evaluate Cost without a Promised Payback
Include equipment, civil work, installation, utilities, tooling, training and ramp-up in the investment scope. Estimate running costs from local rates and a realistic operating plan. Test the effect of utilization, product mix and maintenance assumptions.
A planning calculation should identify its inputs and uncertainties. It should not be presented as an achieved customer result or evidence that an upgrade will pay for itself.
Frequently Asked Questions
Can shot blasting replace pickling?
Assess the required surface condition and the downstream process before deciding. Trial the candidate route with the actual wire and review any functions that still require separate treatment.
Will the line need fewer operators?
Define the remaining loading, inspection, changeover and maintenance tasks. Staffing must follow the operating and safety plan; it cannot be inferred from an automation label.
What maintenance needs attention?
Follow the equipment-specific instructions for blast components, liners, seals, abrasive recovery, extraction and wire handling. Set intervals from the duty and condition checks rather than a generic monthly rule.
Contact Hitech-China with wire specifications, samples, the current process map and the required acceptance criteria to discuss a configuration-specific proposal.
