Evaluating a roller conveyor shot blasting line requires a defined product range, surface specification and complete production cycle. A useful assessment shows whether the proposed process meets those requirements and where it changes the current workflow.
Record the Existing Production Constraint
Map loading, cleaning, inspection, unloading and rework. Identify whether the limiting step is surface treatment, handling, product spacing, changeovers or another operation. Keep the product mix and incoming surface condition with the measurements.
Describe quality problems through the actual inspection criteria. “Inconsistent finish” may refer to visual cleanliness, surface profile, residual contamination or untreated areas; these require different checks. Do not assume every coating defect originates in the blast-cleaning stage.
Confirm Roller-Conveyor Suitability

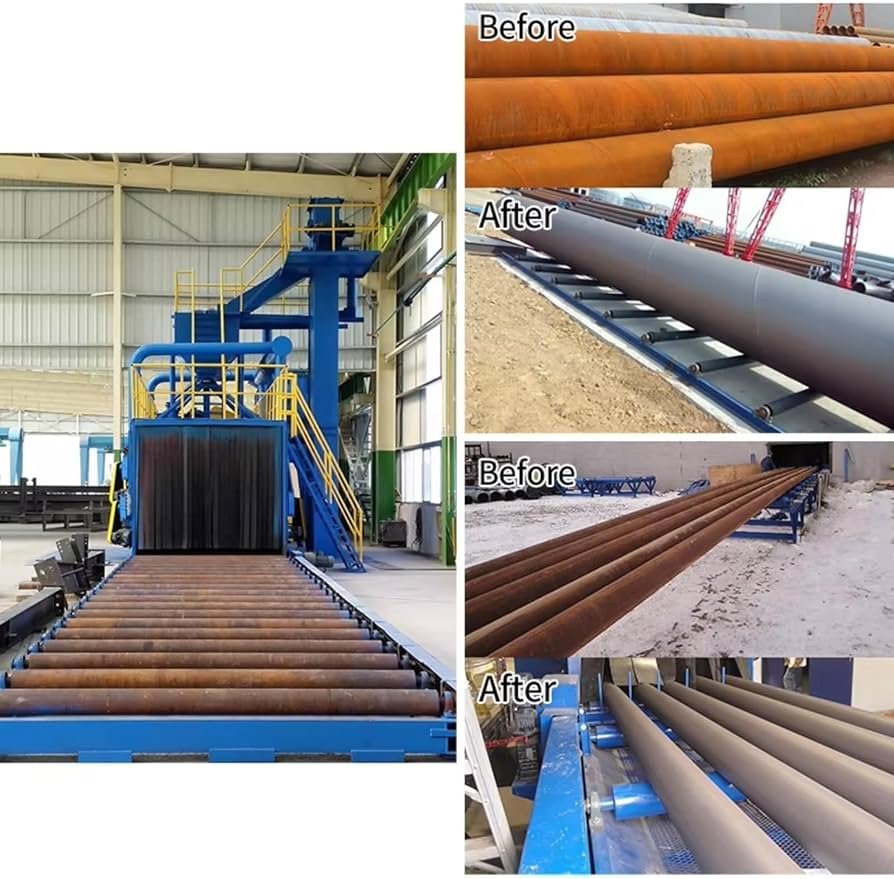

A roller conveyor supports and moves compatible workpieces through the treatment zone. Verify support spacing, transfer stability, load limits and the full product envelope. Plates, sections, pipes and complex components do not necessarily use the same handling or blast arrangement.

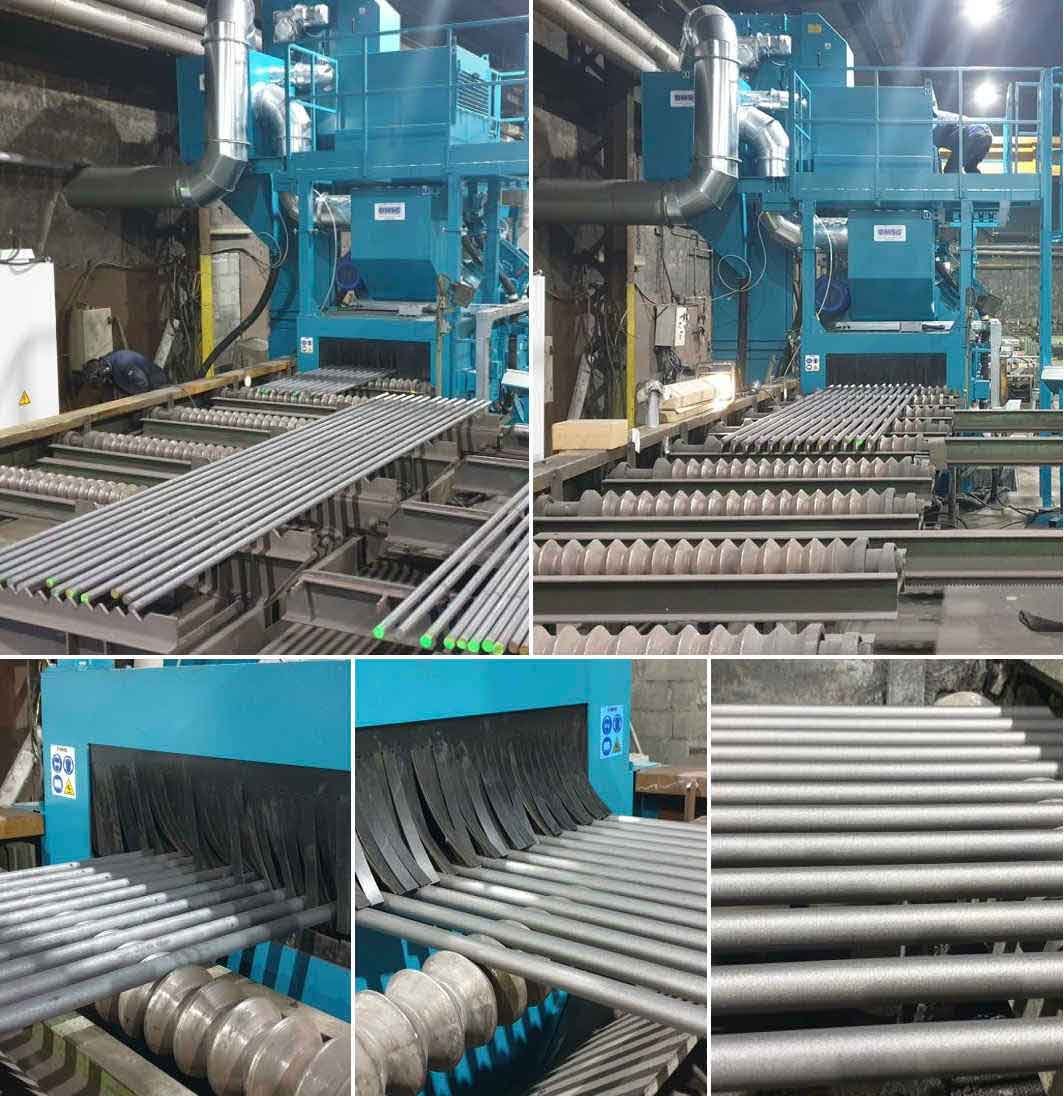

Review the areas hidden by contact, geometry or adjacent products. Determine whether the required surfaces can be exposed in the proposed orientation. A roller conveyor is not a belt conveyor, and its support arrangement must be assessed as part of process selection.
Define the Proposed Treatment Process
Identify wheel positions, abrasive characteristics, working mixture and permitted process settings. Include recovery, separation, extraction and final cleaning as applicable. Establish the required visual condition, profile and relevant contamination checks from the downstream specification.
Use representative trial products and inspect difficult areas as well as easily reached surfaces. Record settings, load spacing and incoming condition. A successful trial supports the tested operating envelope; it does not prove every possible product or future production rate.
Measure Output Across the Complete Cycle
| Review measure | Comparison basis |
|---|---|
| Accepted output | Products passing the same inspection in a defined period |
| Cycle and handling time | Loading, treatment, unloading and any additional operation |
| Labour | Actual tasks during setup, production, inspection and recovery from faults |
| Energy | Complete stated equipment boundary and comparable workload |
| Abrasive use | Additions and inventory change, separated from recirculated flow |
| Maintenance | Relevant parts, work and interruptions over a stated period |
Do not convert a shorter blast time directly into a line-output increase. Upstream supply, downstream inspection and product changeovers may limit usable capacity. Explain differences in workload when comparing records.
Plan Installation and Handover
Prepare a dimensioned layout covering infeed, outfeed, utilities, extraction, maintenance and safe access. Agree responsibilities for foundations, transfers, controls and commissioning. The installation schedule should reflect the actual work; a generic weekend-installation promise is not a planning basis.
Define guarding, interlocks, emergency response and safe isolation procedures. Train the relevant personnel in approved loading, settings, inspection and fault handling. Keep optional automation or monitoring functions explicit in the supply agreement.
Evaluate Financial and Environmental Questions Separately
Use the installed investment and supported operating assumptions to evaluate economics. Identify the evidence behind any projected reduction in expenditure, and include the cost of integration and ongoing maintenance. A payback period cannot be established from the machine type alone.
Assess extraction, emissions and waste handling for the actual installation. Abrasive recycling does not prove a fixed waste reduction or automatic regulatory compliance. Retain commissioning and inspection records for the relevant systems.
Make the Acceptance Decision Traceable
Compare the trial and installation evidence with the purchase specification. Record outstanding items, responsibilities and closure criteria. Release the process when the defined requirements are met, keeping forecasts separate from measured operating results.
